A professional roof replacement typically takes 2 to 6 weeks from first inspection to final municipal sign-off, though the active work on top of your house usually wraps up in just 1 to 5 days. That gap surprises most homeowners in Canton and across the Atlanta metro. The physical tear-off and install is the fast part. The paperwork, permitting, and material ordering around it is what stretches the calendar.
Here is what a realistic range looks like for a typical single-family home in the area:
- Fast track: 2 to 3 weeks total, standard asphalt shingles, in-stock materials, no insurance claim
- Typical: 3 to 4 weeks total, including permit review and a short materials wait
- Extended: 6 weeks or longer during storm season when insurance approvals and specialty materials stack up
The single biggest driver of variance isn't the crew, it's what happens before they show up. Permit turnaround, insurance claim approval, and material lead times account for most of the delay homeowners experience, according to the Illinois Roofing Institute's contractor guide. Manufacturers like Owens Corning outline a fairly consistent day-by-day process for the physical work itself, and a repair-first contractor like The Original Roof Repair Company builds its scheduling around those upstream steps, not around rushing the crew.
Key Takeaways
A roof replacement typically takes 2 to 6 weeks from inspection to final sign-off, with active on-roof work finished in 1 to 5 days depending on material and complexity.
| Point | Details |
|---|---|
| Inspection is fast | A thorough inspection takes 30 to 90 minutes, with a written estimate following in 1 to 3 days. |
| Install time varies by material | Asphalt typically runs 2 to 4 days on-roof; tile and slate can take 5 to 10 days. |
| Permits and insurance drive delays | Permit approval can take 3 to 21 days, and insurance claims often add 1 to 3 weeks. |
| Schedule early, prep your property | Book inspections in off-peak seasons and clear driveways, yards, and gutters before install day. |
| The Original Roof Repair Company manages the details | Free inspections, insurance claim advocacy, and permit coordination are handled for Canton and Atlanta-area homeowners. |
Table of Contents
- How Long Does a Roof Replacement Take, Stage by Stage?
- What Happens During Each Step of a Roof Replacement?
- How Long Does Roof Replacement Take by Material and Size?
- What Factors Change the Roof Replacement Timeline?
- How Do Insurance and Permits Affect the Schedule?
- How Can Homeowners Speed Up a Roof Replacement?
- How The Original Roof Repair Company Manages Scheduling
- What Happens After the Roof Is Installed?
- A Local Perspective on Realistic Timelines
- Ready to Get a Real Timeline for Your Roof?
- Sources
- FAQ
How Long Does a Roof Replacement Take, Stage by Stage?

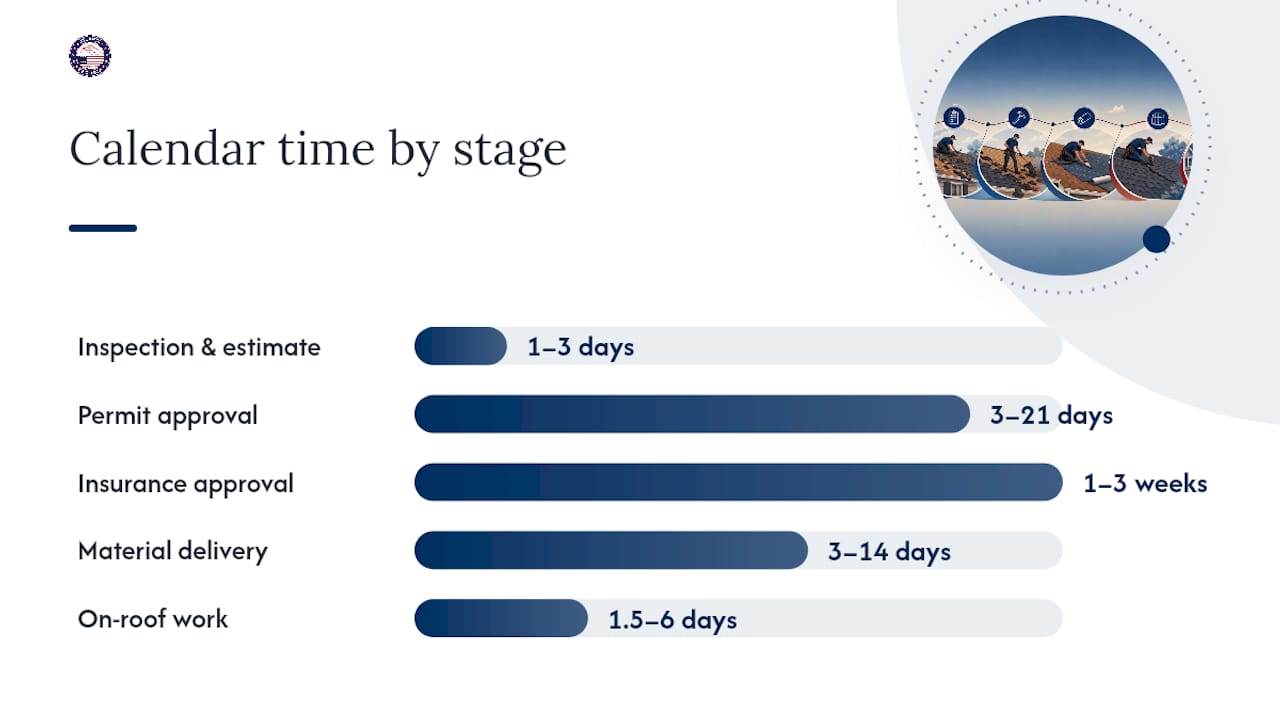

Before you can plan around a roof replacement timeline, it helps to see the whole schedule at once. Here's a quick-reference breakdown of where the calendar time actually goes.
| Stage | Typical Duration | Notes |
|---|---|---|
| Inspection & written estimate | 30–90 minutes on-site, 1–3 days for the quote | Photos and measurements drive the estimate |
| Permit application & approval | 3–21 days | Varies by jurisdiction and workload |
| Insurance claim approval (if applicable) | 1–3 weeks | Adjuster visit is usually the bottleneck |
| Material ordering & delivery | 3 days to 2 weeks | Longer for metal, tile, or specialty colors |
| Tear-off | Half a day to 1 full day | Faster on single-layer asphalt roofs |
| Installation (on-roof work) | 1 to 5 days | Depends on material and roof complexity |
| Cleanup & final inspection | 1–5 business days after the request | Closes the permit and issues completion paperwork |

Three quick examples show how these stages combine in practice. An average asphalt job on a straightforward Canton ranch home might run 2 to 3 weeks total, with installation wrapped in two days. A complex roof with steep pitch, dormers, or tile can stretch to 5 to 6 weeks once specialty material lead times and extra crew hours are factored in. An insurance-claim job following hail damage often lands in the 4 to 8 week range, simply because the adjuster visit and claim approval have to happen before material ordering even starts.
Permits, materials, and insurance approvals eat the most calendar time. The actual nailing of shingles is almost never the bottleneck.
What Happens During Each Step of a Roof Replacement?
Understanding the roof installation schedule stage by stage helps you know what's normal and what's a red flag. Here's the typical sequence:
- Initial inspection and measurement — 30 to 90 minutes on-site to photograph the roof, check the deck for soft spots, and take rooftop measurements. A written estimate typically follows within one to three days.
- Contract signing and material selection — Usually same-day to a few days, depending on how quickly you choose shingle color, metal profile, or tile style.
- Permits and scheduling — Filed once the contract is signed; approval windows vary by county and season.
- Material delivery and staging — Materials are delivered and staged in the driveway or yard shortly before the crew arrives.
- Tear-off — A single-layer asphalt roof on an average home often comes off in one day.
- Deck inspection and repairs — Crews check for rot, delamination, or soft plywood; repairs typically add a half-day to two days if damage is found.
- Underlayment and flashing installation — Usually completes the same day as tear-off, before any exposed decking sits overnight.
- Roofing material installation — For a 2,000 to 2,500 square foot asphalt roof, an experienced 4 to 6 person crew finishes in 2 to 4 days.
- Ridge and vent work, finishing details — Typically the final few hours of the install phase.
- Cleanup and nail sweeps — Magnetic sweeps and dumpster removal, usually same-day.
- Final inspection and paperwork — Scheduled 1 to 5 business days after the contractor calls it in.
Crews often work in sections, tearing off and installing one portion of the roof at a time rather than stripping the whole deck at once. That sectional approach limits how long your decking sits exposed and is part of why a 4 to 6 person crew can still finish an average asphalt roof in two to four days.
Pro Tip: Ask your roofer whether they'll tear off in sections or all at once. Sectional work is usually the safer choice if there's any chance of afternoon storms.
- Larger crews (6 or more) move faster on straightforward asphalt roofs but offer little advantage on tile or slate, where the work is more hand-fitted than fast-paced.
- A single missed weather window can push a two-day job into a three-day job even with a full crew on-site.
How Long Does Roof Replacement Take by Material and Size?
The material you choose affects both the on-roof install window and the full roof replacement process time, since specialty products require more precise fabrication and setting.

| Scenario | On-Roof Install Time | Full Project Range |
|---|---|---|
| Small/simple asphalt roof | 1 to 2 days | 2 to 3 weeks |
| Medium/average asphalt roof (2,000–2,500 sq ft) | 2 to 4 days | 2 to 4 weeks |
| Standing-seam metal | 4 to 7 days | 3 to 5 weeks |
| Tile | 5 to 10 days | 4 to 6 weeks |
| Cedar shake | 4 to 8 days | 3 to 5 weeks |
| Slate | 7 to 10 days | 5 to 8 weeks |
These ranges shift for specialty materials because tile and slate require careful hand-setting rather than fast nailing, and metal often needs on-site or shop fabrication for seams and flashing. A steep pitch, a large number of roof penetrations (skylights, chimneys, multiple vents), or a two- to three-story home each add time on top of the base range, mostly because crews have to move slower and rig additional safety equipment.
What Factors Change the Roof Replacement Timeline?
Some delays are predictable, and knowing the approximate impact helps you plan around them rather than get blindsided.
- Weather: Rain or high wind can add 1 to 5 days, especially in Georgia's spring and summer storm patterns.
- Permit processing: Ranges from 3 days in smaller jurisdictions to 21 days in busier counties.
- HOA approval: Can add a week or more if design review is required before permitting.
- Insurance claims: Adjuster scheduling and approval commonly add 1 to 3 weeks before material ordering can even start.
- Material lead times: In-stock asphalt ships fast; specialty colors or metal panels can add one to two weeks.
- Hidden deck damage: Rotted plywood found during tear-off typically adds one to two days for repair.
- Crew scheduling: Peak season (late spring through fall storm season) means booking further in advance.
- Site access: Difficult driveway access or dumpster placement can slow material staging by a day.
Pro Tip: If your roofer offers a choice of shingle colors, ask which ones are in-stock at the distributor. Custom color orders are one of the most common, and most avoidable, sources of delay.
How Do Insurance and Permits Affect the Schedule?
If a storm caused your roof damage, insurance becomes the biggest variable in your roof repair timeline. Here's the realistic sequence:
- Documentation and inspection — Your roofer photographs and documents damage, often the same day as the initial inspection.
- Adjuster visit — Usually scheduled within a week, though storm-heavy periods can push this out further.
- Claim approval — Typically 1 to 3 weeks after the adjuster visit, depending on the carrier.
- Material approval and scheduling — Once approved, ordering and crew scheduling begin, adding another 1 to 2 weeks.
On the permit side, Cherokee County and most metro Atlanta jurisdictions process residential roofing permits within a few days to three weeks, depending on current workload. Your contractor typically pulls the permit on your behalf, though you should confirm this is included before signing.
A few homeowner actions genuinely speed both processes:
- Take clear photos of storm damage immediately, before any tarping or cleanup
- Sign insurance-related release forms as soon as your contractor requests them
- Give your adjuster and contractor a wide scheduling window rather than a single narrow date
The Original Roof Repair Company handles the documentation, adjuster communication, and claim advocacy directly. Homeowners are responsible for approving the estimate, confirming the claim details with their carrier, and signing off on the final paperwork.
Pro Tip: Photograph roof damage from the ground and, if safe, from a ladder, right after a storm. Adjusters move faster when the evidence is already organized.
How Can Homeowners Speed Up a Roof Replacement?
A little preparation on your end can shave real days off the schedule. Before the crew arrives:
- Clear vehicles and outdoor furniture from the driveway and yard
- Move fragile items away from the house, especially near windows and patios
- Secure pets indoors or off-site for the day
- Confirm attic access and note any interior areas sensitive to noise or vibration
- Submit HOA approval requests early if your neighborhood requires them
The day before and day of installation:
- Confirm the material delivery window with your contractor
- Identify where the dumpster and staging area will sit
- Ask about tarp plans if rain is possible mid-project
- Trim overhanging tree limbs near the roofline in advance
- Clear gutters so debris doesn't back up during tear-off
Letting neighbors know work is starting, and roughly what hours to expect noise, is a small courtesy that avoids awkward conversations mid-project. Most crews work standard daytime hours, so plan any work-from-home days accordingly.
How The Original Roof Repair Company Manages Scheduling
The Original Roof Repair Company builds every roof replacement around a straightforward sequence: free inspection and written estimate, clear contract terms, permit and insurance claim coordination, scheduled material delivery, a day-by-day onsite plan, and a final inspection and cleanup policy that closes out the job properly.
- Free inspections and written estimates for homeowners across Canton, Cherokee County, and 11 surrounding counties
- BBB accreditation and direct insurance claim advocacy with carriers and adjusters
- A clear policy: full replacement is recommended only when a repair estimate exceeds $4,000
That $4,000 threshold matters for scheduling, not just cost. Once a job crosses into replacement territory, it moves into the full permit, material, and crew-scheduling pipeline rather than a same-week repair visit. Homeowners deserve to know upfront which track their roof is on.
Clients should expect clear communication about weather buffers built into the schedule and a final walk-through once the municipal inspection closes the permit.
What Happens After the Roof Is Installed?
A roof replacement doesn't end the moment the crew leaves. Most contractors, including The Original Roof Repair Company, schedule a final walk-through with the homeowner within a day or two of completing cleanup, separate from the municipal final inspection described earlier.

If you notice a loose shingle, a minor leak, or debris missed during the nail sweep, reputable roofers typically respond to warranty callbacks within a few business days rather than weeks. Manufacturer warranties on materials like Owens Corning shingles also start the clock at installation, so it's worth confirming registration happens promptly. Keep your final paperwork and warranty documents together. They matter for resale and for any future insurance conversations tied to the new roof.
A Local Perspective on Realistic Timelines
Homeowners in Canton and around Atlanta often ask me why one neighbor's roof took a week and theirs is projected for three. The honest answer is almost always permits, materials, or insurance, not the crew on the roof. I've seen straightforward asphalt jobs get held up two extra weeks simply because a homeowner picked a shingle color that had to be special-ordered. Plan the choices you control, the material and the scheduling window, and the parts you don't control become a lot easier to accept.
If you're trying to figure out where your project would land on this timeline, the fastest way to get a real answer is a free inspection. We'll walk the roof, measure it, and give you a written estimate with a realistic schedule attached, not a guess.
Ready to Get a Real Timeline for Your Roof?
If your roof needs attention, guessing at the schedule doesn't help you plan time off or coordinate with your family. The Original Roof Repair Company gives Canton and metro Atlanta homeowners a free inspection and a written estimate that includes an actual project timeline, not just a price.

Our process covers what most homeowners worry about most: insurance claim advocacy if storm or hail damage caused the problem, permit coordination so you're not chasing paperwork, and a clear day-by-day plan once material is on-site. We serve Canton, Cherokee County, and 11 surrounding counties across the Atlanta metro area, and we're BBB accredited. For urgent situations, our emergency roof repair service responds faster than a standard replacement schedule, since active leaks and storm damage can't wait for a routine booking window.
If your roof shows damage but you're not sure whether it needs full replacement or just a targeted repair, schedule your free roof replacement inspection today and get a real answer, backed by a real schedule.
Sources
- What to Expect During Roof Replacement - IKO North America
- Roofing Process Step by Step: What to Expect | Owens Corning Roofing
- How to Determine a Roofing Project Timeline (Contractor Guide 2026)
- How Long Does a Roof Replacement Take? Real 2026 Timeline | The Roofing Brief
FAQ
How long does a roof replacement take from start to finish?
Most residential roof replacements take 2 to 4 weeks from the first inspection to the final municipal inspection, though storm season or insurance claims can extend that to 6 weeks or more.
How long does the actual roof installation take?
Active on-roof work for an average asphalt shingle roof usually takes 2 to 4 days with a 4 to 6 person crew; tear-off alone often finishes in a single day.
How long does roof repair take compared to full replacement?
Most standalone roof repairs, like a flashing fix or a section of missing shingles, are completed in a single day, while full replacement involves permits, material ordering, and a multi-week schedule.
Does insurance slow down the roof replacement timeline?
Yes. Insurance claims typically add 1 to 3 weeks for adjuster review and approval before material ordering and scheduling can even begin.
